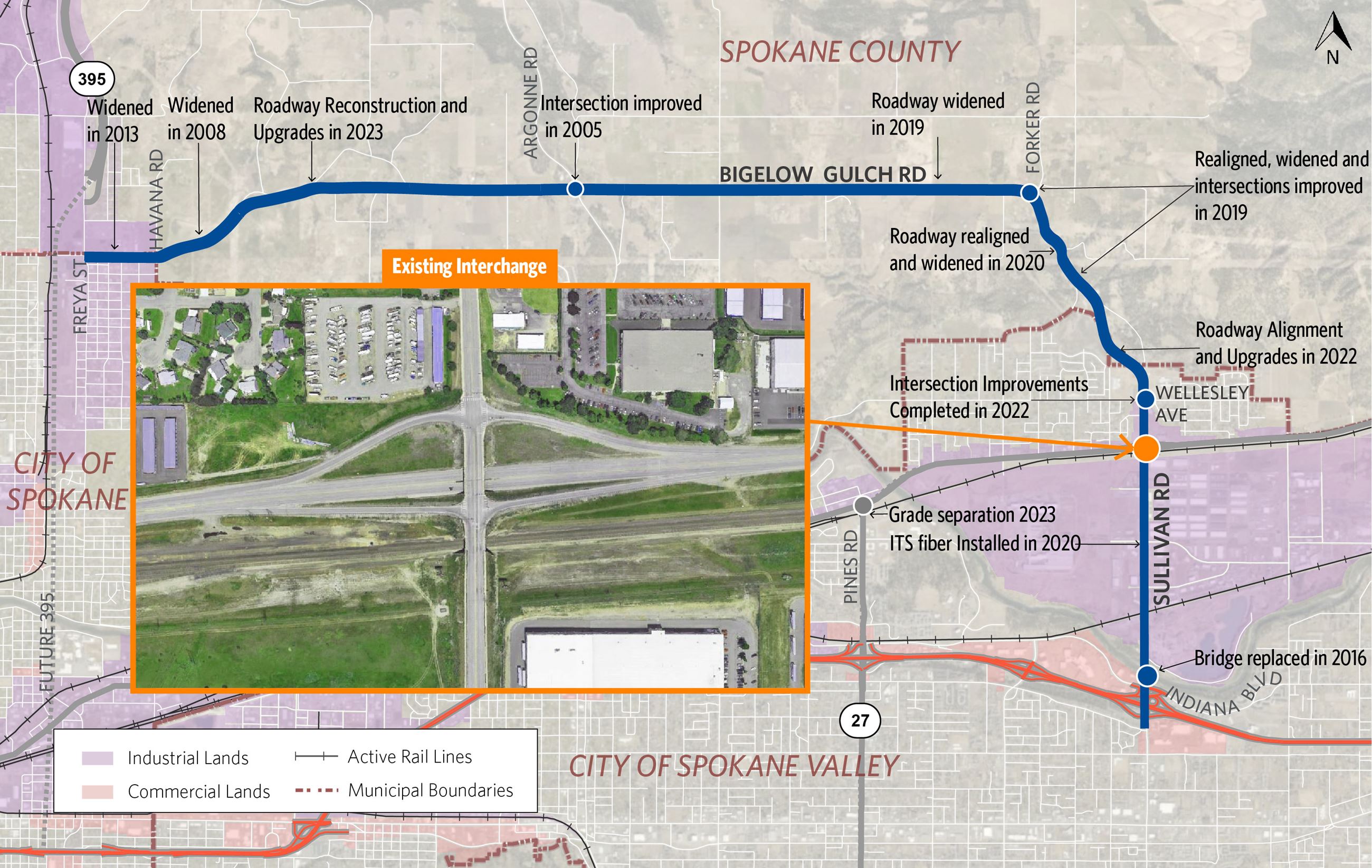

Sullivan Road / Trent Avenue Interchange

The City is planning to reconstruct the existing interchange at Sullivan Road and Trent Avenue (SR 290). This project replaces both Sullivan Road bridges over the BNSF Railway tracks and four lanes of Trent. The existing signalized intersections will be replaced with a "peanut" roundabout. The project seeks to improve mobility and safety for all users: vehicles, pedestrians and bicyclists. A shared-use path will be added along Sullivan's west side and a new, wider sidewalk will be built on the east side.

The city evaluated four potential new interchange configurations in fall 2022. The city's process included collaboration with the Washington State Department of Transportation (WSDOT), BNSF Railway, regional stakeholders, neighboring industries, and the general public. In December 2022, city council passed a motion selecting Alternative 2 - Diamond Interchange with Peanut Roundabouts as the selected, preferred alternative.

  1. 1
  2. 2

RAISE FY23 Funding Request

The project's estimated total cost is $42.2 million. In spring 2023, the city submitted a grant application for $17.2 million (PDF) to the USDOT's Rebuilding American Infrastructure with Sustainability and Equity (RAISE) discretionary grant program. The City also submitted various funding requests to WSDOT, the Washington state legislature and the U.S. Congress. Funding programs will announce their awards likely by fall or winter 2023.

The city has secured approximately $6.6 million of federal and local funds to deliver the engineering and right-of-way phases of the project. The city is now pursuing construction phase funding. A funding breakdown of the overall project (as of March 2023) is provided:

Future Eligible Project Costs

Project Schedule

The City initiated the engineering phase in March 2023. Engineering, environmental and Right-of-Way phases are scheduled to occur in 2023 and 2024. The construction timeline is dependent on funding.

PhaseBegin End
Design EngineeringMarch 2023December 2024
Environmental Documents (NEPA) August 2023March 2024
 Right-of-WayApril 2024December 2024
ConstructionUnfunded
Public EngagementApril 2019Ongoing

Letters of Support

The project has been a federal agenda priority for Spokane Valley since 2019. Partnerships include Spokane County, WSDOT, BNSF Railway, Spokane Regional Transportation Council, and a variety of local and regional stakeholders and freight industry representatives. View letters of support.

Selection of Alternative

Learn more about the city's 2022 evaluation of the four alternatives:

Title VI Notice to Public

It is the policy of the City of Spokane Valley to assure that no person shall, on the grounds of race, color, national origin, or sex, as provided by Title VI of the Civil Rights Act of 1964, and related State and Federal Statutes, be excluded from participation in, be denied the benefits of, or be otherwise discriminated against under any of its federally-funded programs and activities. Any person who believes his/her Title VI rights have been violated may file a complaint via email with the City's Title VI Administrator or call 509-720-5111.

The City of Spokane Valley in accordance with Section 504 of the Rehabilitation Act (Section 504) and the Americans with Disabilities Act (ADA), commits to nondiscrimination on the basis of disability, in all of its programs and activities. This material can be made available in an alternate format by emailing John Whitehead or by calling 509-720-5111.
